Contents
Identifying whether a wall is load-bearing and what structural opening work involves
**How to determine whether a wall is load-bearing**:
The term 'load-bearing' refers to any wall that carries a structural load — the weight of floors, roofs, or other walls above it — and transfers that load down to the foundations. A non-load-bearing wall (also called a partition wall) does not carry structural load and can typically be removed without structural engineering input (though party walls and walls with fire separating functions still have regulatory implications even if they are non-structural).
Determining whether a wall is load-bearing is not always straightforward from visual inspection alone — particularly in London Victorian terraces, where the original construction used structural elements that are not always obvious to the non-expert eye. The definitive answer requires a structural engineer to assess the wall and its context.
*Indicators that a wall is likely to be load-bearing (but not conclusive without structural assessment)*:
1. *Position in the house plan*: Walls that run perpendicular to the floor joists typically bear the joist ends and are more likely to be load-bearing. In a London Victorian terrace (which runs from front to back), the floor joists typically span from the party wall to the centre of the house (where a central spine wall runs front-to-back) — so the party wall and the central spine wall are typically load-bearing.
2. *Wall thickness*: Original load-bearing walls in London Victorian terraces are typically 225mm (9-inch solid brick) or 327mm (13-inch solid brick). Internal partition walls are typically 112mm (4.5-inch half-brick) or 75mm (timber studwork). A thicker wall is more likely to be structural.
3. *Stacking of walls on multiple floors*: If the wall in question has a wall directly above it on the floor above, and another above that, the stack of walls is transferring load from floor to floor and is very likely structural.
4. *Chimney breast*: Chimney breasts are always structural elements — they form part of the original load path through the building. A chimney breast is not simply a decorative feature; it bears the weight of the chimney stack above (and potentially roof rafters where the chimney passes through the roof). See the chimney breast section below.
5. *Presence of timber or steel above the wall*: If you can see a timber or steel beam at or near ceiling level running parallel to the wall, this may be a beam that has already been inserted to carry the load from a previous modification — indicating that the wall was (or is) structural.
*Definitive identification — what the structural engineer does*:
- The structural engineer will:
- •Inspect the wall visually — thickness, material, and context
- •Open up investigation hatches or 'opening up works' where the structure cannot be determined without physical investigation (e.g., lifting a floorboard above to see whether joists bear on the wall)
- •Carry out a load take-down from the roof to the foundations, tracing the load path through the building to assess whether the wall in question is in the load path
- •Confirm in writing whether the wall is structural, and if so, the loads that a new steel beam must carry if the wall is to be removed or partially removed
**What happens structurally when a load-bearing wall is removed**:
When a load-bearing wall is removed, its load-carrying function must be transferred to a new structural element — typically a steel beam (RSJ, Universal Beam, or Rectangular Hollow Section) supported on padstones or steel columns at each end of the opening.
The load that the new beam must carry is the full structural load that the wall was carrying — the weight of the floors, roof elements, and any walls above. In a typical London Victorian terrace ground floor removal:
- •The first floor joists bear on the wall — these must now bear on the new steel beam at each end
- •Any walls on the first floor directly above the removed ground-floor wall must also transfer their loads through the steel beam
- •The roof structure (via the intermediate floors) may also contribute some load to the beam through the stacked load path
This is why a structural engineer's calculations are essential — the calculation determines the required beam size (depth, flange width, steel grade) to carry the specific load, the required bearing length at each end (padstone design), and the required foundation capacity at the support points.
**Chimney breast removals — a special case**:
Chimney breast removal is a common works item in London Victorian terrace refurbishments — clients want to free up floor space in bedrooms, living rooms, and rear kitchens by removing the projecting chimney breast. It is also one of the most commonly mis-executed structural works in London residential construction.
*Why chimney breast removal is technically demanding*:
- •Removing a chimney breast at first-floor level (leaving the stack supported at loft level and the chimney breast in the room below) requires 'gallows brackets' — proprietary steel hangers that transfer the load of the remaining chimney stack to the party wall or adjacent structural wall. These must be designed by a structural engineer and approved by Building Control.
- •Removing a chimney breast at ground-floor level only (leaving the breast at first floor and above) creates a cantilever load on the breast above — which must be assessed for stability by a structural engineer.
- •Removing all chimney breasts on all floors requires the removal of the chimney stack above roof level (a separate work item involving scaffolding, rebuilding the brick course above, and a new roof finish at the penetration point).
- •Chimney breast removal is a notifiable work under the Party Wall Act where the breast is at or adjacent to the party wall (which it typically is in a London terrace).
How a structural opening is installed — the construction process step by step
**Step 1 — Structural engineer's design and Building Control approval**:
- Before any structural opening works begin on site, the structural engineer must produce:
- •Load take-down calculation: confirming the load the beam must carry
- •Beam design: specifying the beam size (e.g., 178×102 UB 19 — a 178mm deep, 102mm wide, 19 kg/m Universal Beam in S275 steel), the steel grade (typically S275 or S355), and the span
- •Padstone design: specifying the padstone (the concentrated bearing block that spreads the point load from the beam end into the masonry wall) — typically a 100mm or 140mm deep engineering brick padstone or a concrete padstone, with dimensions calculated to distribute the end reaction load within the bearing capacity of the masonry below
- •Temporary propping layout: where the beam is to be installed in an existing building, specifying the temporary propping arrangement that will support the load while the beam is installed
The structural engineer's calculations are submitted to Building Control with the Building Regulations application (Full Plans application). Building Control will review and approve the structural design before issuing approval for the works to proceed.

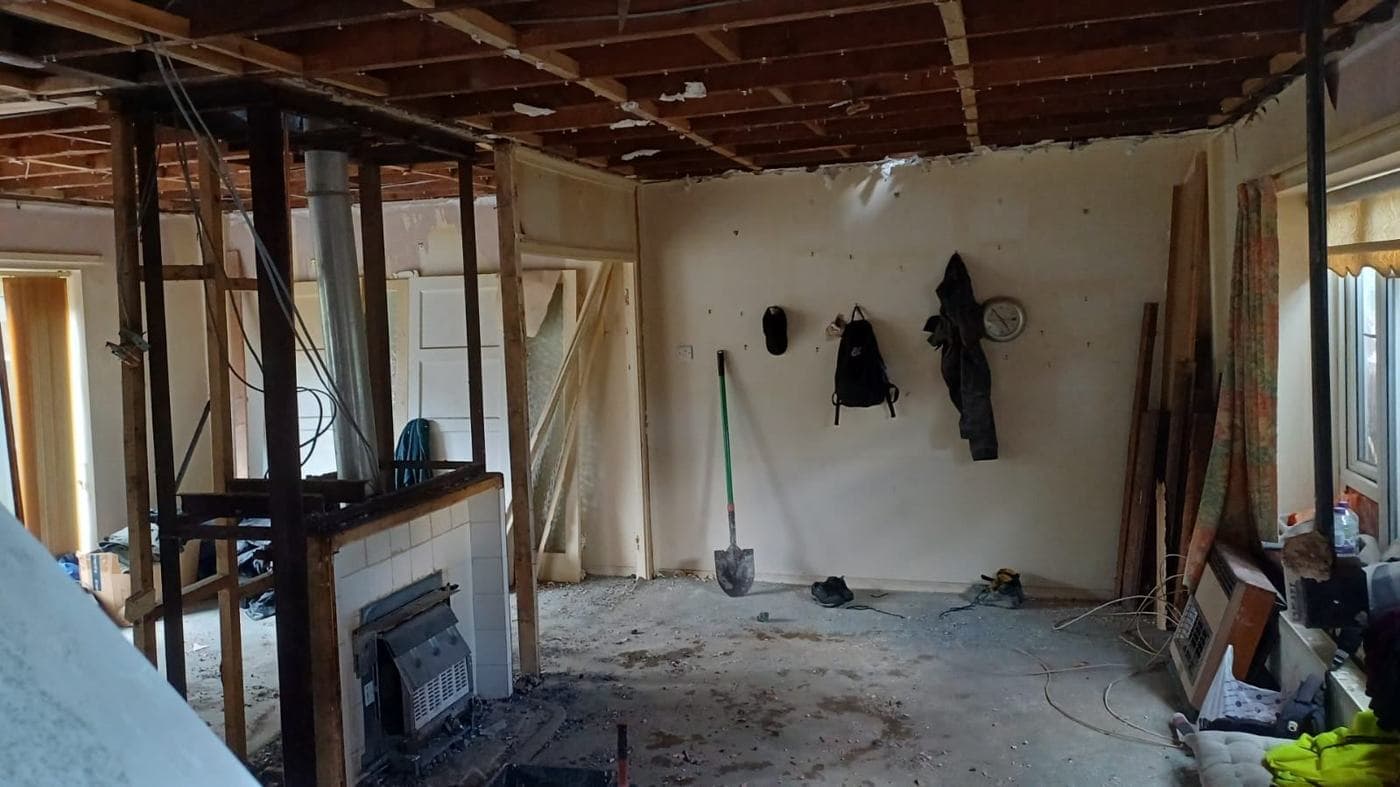

**Step 2 — Temporary propping**:
Before any element of the load-bearing wall is removed, the loads above must be temporarily supported by props:
*Acrow props and temporary needles*: The most common temporary propping system for a domestic structural opening. Acrow props (adjustable screw-jack props) are positioned on each side of the wall (ground floor below; first-floor ceiling above) and tightened to take the load. 'Needle' timbers (typically 150×150 or 200×100 C24 softwood) are threaded through temporary holes made in the wall below the first floor, supporting the floor joists above while the wall is removed. The needle-and-prop arrangement carries the joist load while the opening is formed.
*Important*: The propping arrangement must be designed and checked by the structural engineer (or a competent site manager) before installation. Incorrect propping — props not positioned directly under the load path, or props on inadequate bases — can cause collapse during the works. This is the most common cause of construction site accidents on domestic structural opening works.
**Step 3 — Forming the opening**:
With temporary propping in place: 1. Mark the opening position on the wall — confirming the lintel bearing positions (typically 100–200mm minimum bearing on each side of the opening) 2. Cut the masonry at the lintel bearing positions first — making the 'pockets' for the padstones and the beam ends to sit in 3. Install the padstones in mortar — allowing them to set before the beam is placed 4. Install the steel beam — the beam is typically manoeuvred into position on the padstones by hand (for shorter beams up to 3.0m) or with a chain block and temporary lifting arrangement for heavier beams. The beam ends are set into the padstone pockets and checked for level 5. Remove the wall below the beam — now that the beam is in place and bearing on the padstones, the wall section beneath can be removed 6. Clean and finish the reveal of the opening (brick or block lining to the reveal if exposed; plaster returned to the finished opening)
**Step 4 — Fire protection of the steel beam**:
- Under Approved Document B (Fire Safety) and the standard specification for residential buildings, structural steel must be protected from fire:
- •For domestic residential buildings (houses and flats up to 2 storeys): steel beams typically require 30-minute fire protection
- •For buildings over 2 storeys: 60-minute fire protection may be required
- *Methods of fire protection for steel beams in domestic extensions*:
- •Intumescent coating: a paint applied to the exposed steel surface that expands when heated, forming a char layer that insulates the steel for the required period. Applied by brush or spray; available in a range of fire ratings (30/60/90 minutes). Provides fire protection with minimal thickness addition (typically 1–3mm)
- •Encasement in plasterboard: boxing the steel beam in two or three layers of Type F (fire-rated) plasterboard, creating a plastered box around the beam that provides both fire protection and a finished ceiling surface. The most common approach in domestic loft conversions and extensions where the steel is at ceiling level
**Step 5 — Building Control inspection**:
- Building Control must inspect the structural opening works at the following stages:
- •Before the temporary propping is removed — the inspector confirms that the beam is correctly positioned, the padstones are correct, and the bearing conditions are adequate
- •Before any fire protection or encasement is applied — the inspector checks the beam specification against the structural engineer's drawings
*Important*: Do not case in or plasterboard over the steel beam before Building Control has inspected. Covering the beam before inspection makes it impossible for the inspector to verify the beam specification — and may result in a requirement to expose the beam again.
**Steel beam sizes for typical London residential structural openings (2025)**:
| Opening application | Typical beam size | |---|---| | Ground floor chimney breast removal (single storey) | 152×89 UB 16 or 178×102 UB 19 | | Kitchen wall removal (ground floor, 2-storey above) | 203×102 UB 23 or 254×102 UB 25 | | Ground floor spanning to extension (3.0–4.0m) | 254×146 UB 31 or 305×127 UB 37 | | Ground floor spanning (4.0–5.5m) | 356×171 UB 45 or 406×178 UB 54 | | Ground floor large open plan (5.5–7.5m) | 457×191 UB 67 or 533×210 UB 82 |
Note: these are typical guide sizes only. The actual beam size must be calculated by the structural engineer for the specific project loads, span, and support conditions.
Costs, timelines, and what goes wrong with structural openings in London
**Typical costs for structural opening works in London (2025)**:
| Works item | Typical cost | |---|---| | Non-load-bearing internal wall removal (stud, single room) | £1,200–£2,500 | | Load-bearing wall partial removal with steel beam + padstones (1.0–2.0m span) | £2,500–£4,500 | | Load-bearing wall removal with steel beam (2.0–3.5m span) | £3,500–£6,500 | | Load-bearing wall removal with steel beam (3.5–5.5m span) | £5,000–£10,000 | | Large open-plan structural opening (5.5–7.5m, 2 supporting columns) | £8,000–£18,000+ | | Chimney breast removal at single floor level (gallows brackets if stack remains) | £2,500–£5,000 | | Full chimney breast removal at all floors + stack demolition | £4,000–£9,000 | | Structural engineer's calculations and drawings for one beam | £400–£800 |
Note: these costs are for the structural opening works only — they do not include replastering, redecorating, or making good the surrounding finishes (typically an additional £500–£2,000 depending on the extent of decoration disturbed).
**Common problems with structural openings in London — and how to avoid them**:
*Problem 1 — Works started without structural engineer's calculations*:
By far the most common problem with structural opening works in London residential projects. A homeowner (or a poorly qualified contractor) removes a load-bearing wall or installs a beam based on visual assessment or experience — without a structural engineer's calculation. This is illegal (Building Regulations compliance requires proper structural design for all structural alterations) and dangerous (the beam size selected without calculation may be undersized for the actual load).
Solution: Always obtain structural engineer's calculations before any load-bearing wall removal or beam installation. The fee is small (£400–£800); the risk of not doing it is unlimited.
*Problem 2 — Beam installed without proper padstone bearing*:
A steel beam that bears directly onto the masonry without an adequately sized padstone (the concentrated point reaction load from the beam end is very high — typically 30–80 kN depending on the span and load) can cause local crushing of the masonry under the beam end. This produces cracking of the wall at the beam bearing and potentially settlement of the beam end.
Solution: Always install engineered padstones as designed by the structural engineer. Do not substitute a single engineering brick for a specified concrete padstone, or omit the padstone entirely.
*Problem 3 — Temporary propping not adequate*:
In a rush to install the beam quickly, the contractor removes masonry without establishing adequate temporary propping first. This is the most dangerous failure mode — the load path above the opening is disrupted without support, creating a risk of partial collapse.
Solution: The propping arrangement must be in place and checked before any masonry is removed. The sequence is: prop first, then form opening, then install beam, then remove props.
*Problem 4 — Building Control inspection not booked*:
The contractor installs the beam, boxes it in, and plasters over it before Building Control has inspected. Building Control then requires the beam to be exposed for inspection — requiring the contractor to open up the newly finished ceiling, which damages the plasterwork and delays the programme.
Solution: Book Building Control inspection as soon as the beam is installed and before any encasement or boxing begins. Allow at least 48 hours' notice to Building Control.
Frequently Asked Questions
Do I need a structural engineer to remove a load-bearing wall in London?▼
How long does a structural opening typically take in a London Victorian terrace?▼
What is a padstone and why does every structural steel beam need one?▼
Important Note
This guide is for general information only. Building regulations, planning rules, and legal requirements change regularly and vary by local authority. Always seek professional advice specific to your project and location. RCB Design & Build offers free initial consultations — book your free survey.
